Open Access Solar for Industries in India: Step‑by‑Step

Open Access Solar for Industries in India: Step‑by‑Step
Open Access Solar for Industries in India

In reality, most projects don’t succeed or fail on the headline tariff alone. They succeed on how well the Open Access Solar process in India is executed—how cleanly and predictably you move through feasibility, regulatory approvals, metering readiness, commissioning, and the first few billing cycles.

This practical guide is designed for Indian industrial and manufacturing facilities (especially in states like Haryana, Uttar Pradesh, Maharashtra, and Punjab) that want bankable savings, operational certainty, and minimal execution risk.

We will walk you through:

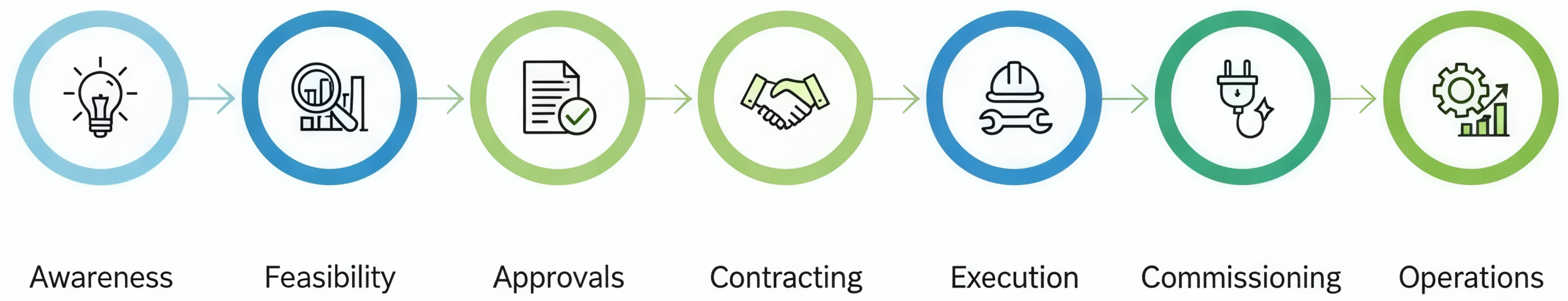

• The complete end-to-end Open Access Solar journey — from site feasibility and energy profiling to GOAR registration, SLDC coordination, metering architecture, and commercial operations.
• What typically goes wrong at each stage — documentation gaps, DISCOM dependencies, metering mismatches, grid synchronization delays, and first-bill reconciliation errors.
• How to de-risk your project using structured checklists, technical proof artifacts, and execution readiness benchmarks.
• What a serious EPC and project partner like Innocepts Solar should demonstrate — real approvals, tested metering layouts, SLDC interface experience, commissioning playbooks, and post-COD billing validation.

Because in Open Access Solar, success is not about chasing the lowest ₹/kWh headline number.
It is about building a process-driven, approval-ready, and grid-compliant project that delivers stable landed power cost year after year.

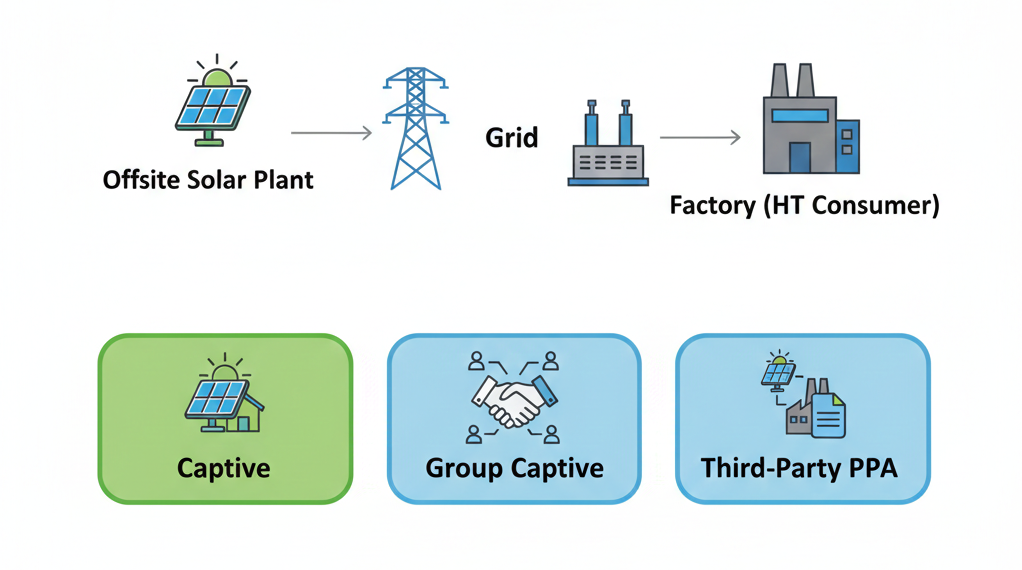

Open Access Solar means your factory procures renewable electricity from an off‑site solar plant (not your rooftop) and receives it through the grid under open access mechanisms. That’s why many teams call it Industrial Open Access Solar—because the process is closer to grid procurement than a normal onsite solar project.

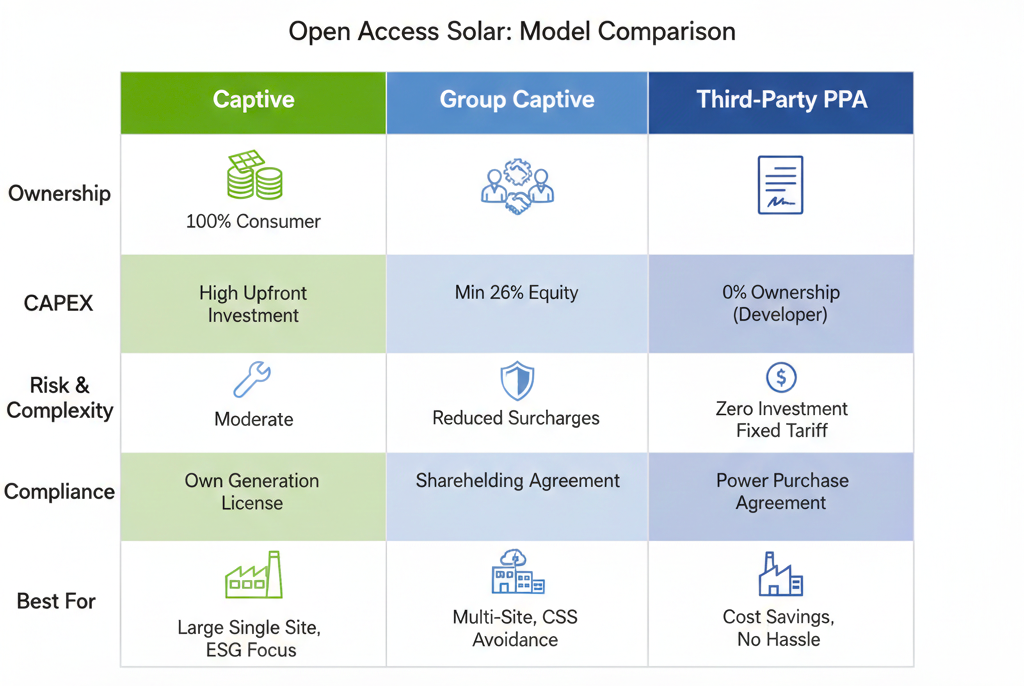

Common structures are:

  • Captive: you own the plant for your own consumption

  • Group captive: multiple consumers co‑own and consume as per captive rules

  • Third‑party PPA: you buy energy from a developer; you don’t own the plant

Captive: you own the plant for your own consumption

Group captive: multiple consumers co‑own and consume as per captive rules

Third‑party PPA: you buy energy from a developer; you don’t own the plant

Open Access Solar for Industries in India

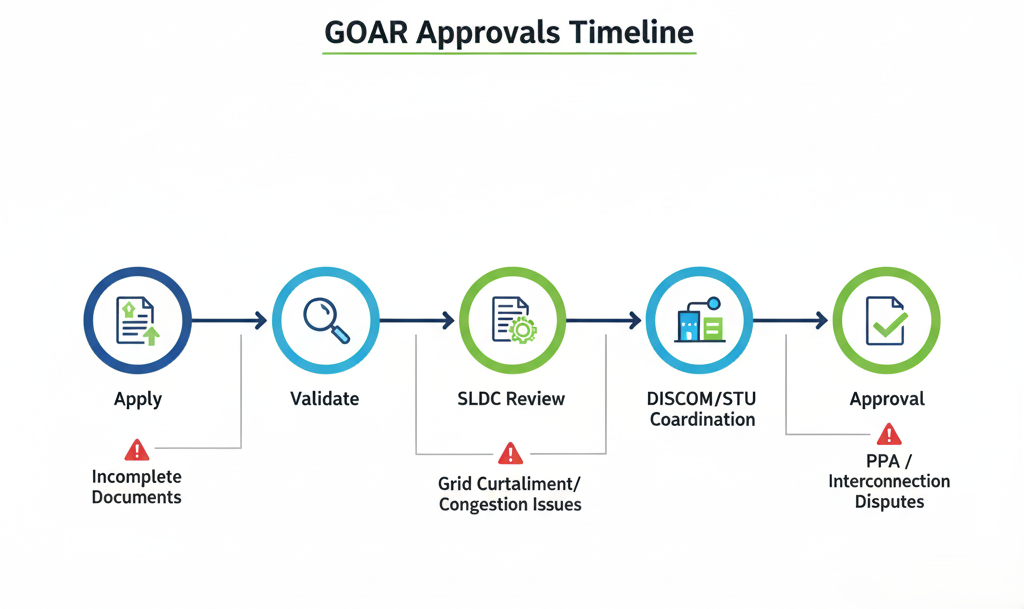

A major reform in India’s open access solar framework is the introduction of the GOAR (Green Open Access Registry) portal, designed to function as a centralized digital registry and a single-window workflow for open access applications, approvals, and tracking.

On paper, GOAR promises faster turnaround — with a benchmark approval timeline of 15 days. In practice, however, many industrial consumers and developers quickly realize that “15 days” can easily stretch into 45–60 days if the project ecosystem is not fully prepared for real-world execution dependencies.

The portal itself is not the bottleneck.
The real challenges typically arise from process readiness across multiple stakeholders and technical layers, including:

1. Documentation Accuracy & Regulatory Compliance

GOAR requires precise and complete documentation at the time of submission. Even minor gaps can trigger rejections or clarification cycles, such as:

  • Incomplete OA agreements

  • Incorrect banking or wheeling structures

  • Inaccurate load profiles

  • Mismatch between plant capacity and contracted capacity

  • Improper captive or group captive shareholding declarations

Incomplete OA agreements

Incorrect banking or wheeling structures

Inaccurate load profiles

Mismatch between plant capacity and contracted capacity

Improper captive or group captive shareholding declarations

A single discrepancy can reset the entire approval clock.

2. Metering Architecture & Interface Readiness

Open access approval is not only a regulatory process — it is a grid-level engineering process.

SLDCs require:

  • ABT / SEM compliant meters

  • Correct metering locations (plant end, pooling substation, consumer end)

  • Proper telemetry and data communication setup

  • Synchronization with SLDC scheduling systems

ABT / SEM compliant meters

Correct metering locations (plant end, pooling substation, consumer end)

Proper telemetry and data communication setup

Synchronization with SLDC scheduling systems

If your metering design is not approved in advance, GOAR approval alone will not allow energy flow.

Practical Takeaway

The GOAR portal is a process accelerator — not a timeline guarantee.
It simplifies the application workflow, but it cannot compensate for incomplete engineering, regulatory gaps, or poor coordination.

A fast approval is only possible when:

  • Documentation is audit-ready

  • Metering design is pre-approved

  • Grid connectivity is locked

  • SLDC & DISCOM workflows are aligned

  • Site readiness is achieved before submission

Documentation is audit-ready

Metering design is pre-approved

Grid connectivity is locked

SLDC & DISCOM workflows are aligned

Site readiness is achieved before submission

Open Access Solar for Industries in India

How Innocepts Makes GOAR Actually Work

At Innocepts Solar, we treat GOAR not as a formality, but as the final layer of a fully engineered execution stack. Our open access solar process is built backwards from commissioning — ensuring that by the time an application hits GOAR.

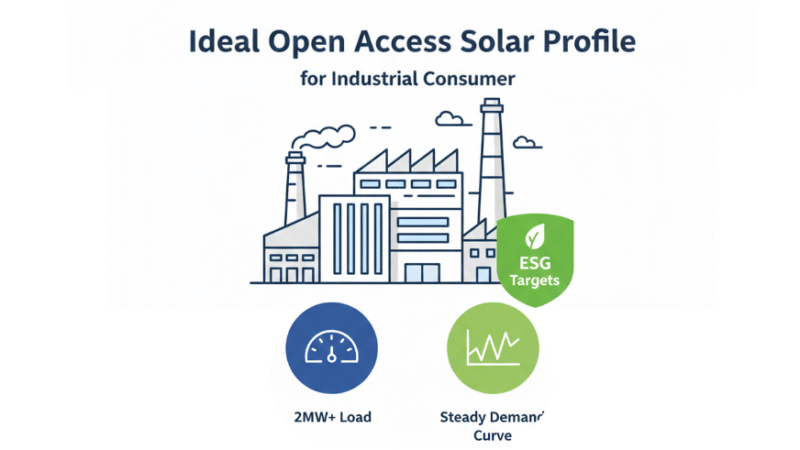

Ideal profiles (2 MW+ loads, multi‑unit groups, ESG targets)

Industrial Open Access Solar is typically considered when you have:

  • large and steady consumption (often 2 MW+ HT consumers)

  • multiple units or connections where aggregation/structure matters

  • ESG or renewable targets requiring verifiable procurement

  • leadership alignment that values “savings + compliance + execution certainty”

large and steady consumption (often 2 MW+ HT consumers)

multiple units or connections where aggregation/structure matters

ESG or renewable targets requiring verifiable procurement

leadership alignment that values “savings + compliance + execution certainty”

This matters because the open access solar process India is not just buying solar energy—it’s managing approvals, metering, settlement, and billing discipline.

Open Access Solar for Industries in India

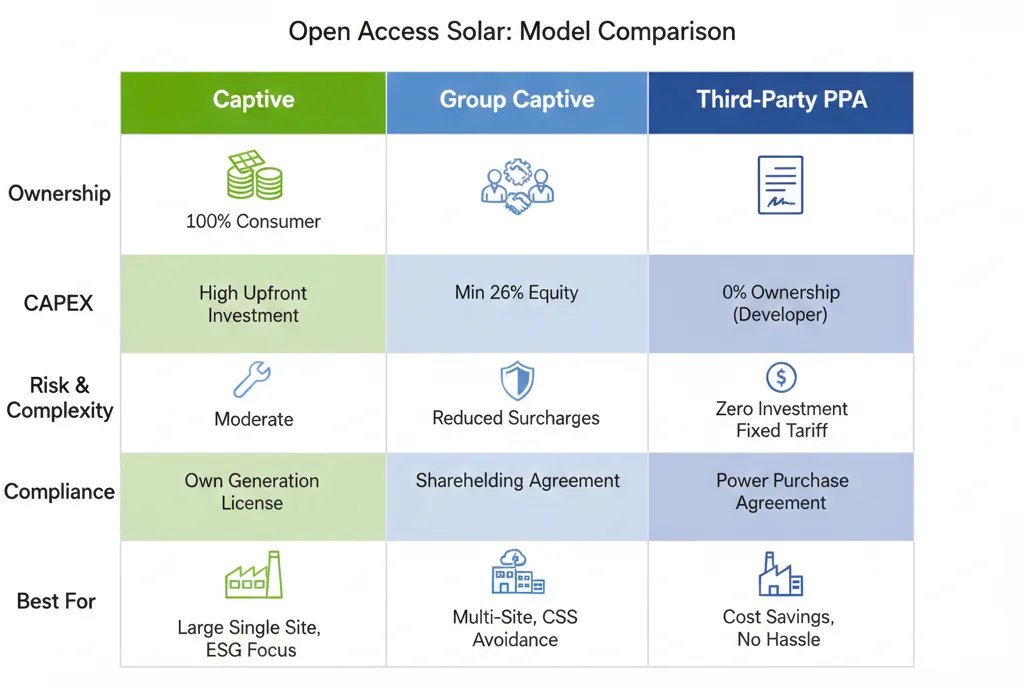

Your open access procurement model is not just a commercial choice — it directly impacts your regulatory compliance obligations, how project and grid risks are allocated, and how stable and predictable your long-term landed power cost will actually feel.

Each model creates a different ownership structure, financial exposure, and operational responsibility. Choosing the right one ensures your solar transition is a strategic advantage, not an administrative burden.

Open Access Solar for Industries in India

Choose Captive if you want full ownership and control of the asset, are comfortable investing upfront capital, and want maximum long-term cost certainty with captive regulatory benefits.

Choose Group Captive if you want to share ownership with other consumers, reduce your capital commitment, and still enjoy captive compliance exemptions such as lower surcharges and banking benefits.

Choose Third-party PPA if you prefer an energy-purchase model with minimal upfront investment, want to keep solar off your balance sheet, and value predictable monthly power bills with operational risk handled by the developer.

At Innocepts Solar, we help you evaluate, structure, and execute the right model for your business—so your open access transition is compliant, bankable, and built for long-term cost stability.

This is the real open access solar process India. The success pattern is consistent: projects that treat approvals + metering + dossier + reconciliation as critical path stay stable; projects that treat them as “paperwork” lose time and savings credibility.

Open Access Solar for Industries in India

What to do

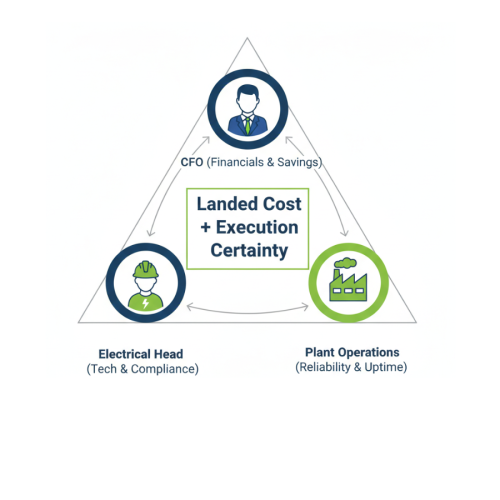

  • Align CFO + Electrical + Plant Head on one metric: landed cost, not headline tariff

  • Define success: saving target, renewable % target, risk appetite

  • Decide your posture: stable landed cost vs maximum savings with more variability

Align CFO + Electrical + Plant Head on one metric: landed cost, not headline tariff

Define success: saving target, renewable % target, risk appetite

Decide your posture: stable landed cost vs maximum savings with more variability

What can go wrong

  • CFO expects fixed ₹/kWh savings; Electrical knows charges and settlement can move it

  • Plant worries about shutdown risk and safety

  • Board trust drops if the story changes after approvals begin

CFO expects fixed ₹/kWh savings; Electrical knows charges and settlement can move it

Plant worries about shutdown risk and safety

Board trust drops if the story changes after approvals begin

How Innocepts Solar should help
An EPC like Innocepts Solar should provide a one‑page risk register and a responsibility matrix so all stakeholders know what they’re agreeing to.

Open Access Solar for Industries in India

What to do
Collect 12 months bills and demand profile, then model the open access solar landed cost (₹/kWh) including:

  • transmission and wheeling charges open access solar

  • cross subsidy surcharge green open access (where applicable)

  • banking charge green open access and banking settlement limits

  • standby charges open access (where applicable)

  • other system operation charges, scheduling/LDC fees, and ToD/DSM impacts (as applicable)

transmission and wheeling charges open access solar

cross subsidy surcharge green open access (where applicable)

banking charge green open access and banking settlement limits

standby charges open access (where applicable)

other system operation charges, scheduling/LDC fees, and ToD/DSM impacts (as applicable)

What can go wrong

  • Tariff is sold as landed cost

  • “Policy volatility” fear isn’t addressed (state orders can change)

  • Curtailment/outage/demand variation isn’t priced

Tariff is sold as landed cost

“Policy volatility” fear isn’t addressed (state orders can change)

Curtailment/outage/demand variation isn’t priced

How to de‑risk

Build a 3‑scenario model:

  1. Base case: current published orders

  2. Conservative case: less banking benefit + higher charges

  3. Operational stress: curtailment + demand variation + ToD/DSM impact

Base case: current published orders

Conservative case: less banking benefit + higher charges

Operational stress: curtailment + demand variation + ToD/DSM impact

What to demand from Innocepts Solar
A transparent sheet with assumptions + a one‑page “board slide” summary.

Open Access Solar for Industries in India

What to do

  • Apply via GOAR portal green open access

  • Coordinate stakeholder approvals, especially SLDC approval open access solar

  • Keep your submission pack version‑controlled and utility‑ready

Apply via GOAR portal green open access

Coordinate stakeholder approvals, especially SLDC approval open access solar

Keep your submission pack version‑controlled and utility‑ready

What can go wrong

  • Portal status ≠ coordination closure (handoffs stall)

  • Repeated revisions of drawings/protection schemes

  • Bay/evacuation/interface constraints discovered late

  • Compliance dossier gaps and inspection dependencies

Portal status ≠ coordination closure (handoffs stall)

Repeated revisions of drawings/protection schemes

Bay/evacuation/interface constraints discovered late

Compliance dossier gaps and inspection dependencies

How to de‑risk

  • Run approvals with a single tracker (owner/date/dependency/pendency reason)

  • Pre‑validate metering specs + protection philosophy + communication requirements

  • Use one point owner for coordination (not “everyone owns it”)

Run approvals with a single tracker (owner/date/dependency/pendency reason)

Pre‑validate metering specs + protection philosophy + communication requirements

Use one point owner for coordination (not “everyone owns it”)

What to demand from Innocepts Solar
An approval tracker dashboard + document control logs.

What to do
Lock these in writing:

  • metering boundary (which meter defines delivered energy?)

  • COD / acceptance criteria and dossier requirements

  • pass‑through vs shared vs absorbed charges (banking/CSS/standby/wheeling)

  • change‑in‑law clause

  • billing dispute workflow + timelines

  • O&M SLA + escalation + spares governance

metering boundary (which meter defines delivered energy?)

COD / acceptance criteria and dossier requirements

pass‑through vs shared vs absorbed charges (banking/CSS/standby/wheeling)

change‑in‑law clause

billing dispute workflow + timelines

O&M SLA + escalation + spares governance

What can go wrong

  • Acceptance criteria unclear → COD disputes

  • Change‑in‑law weak → surprises later

  • Ambiguity on billing boundary → recurring reconciliation fights

Acceptance criteria unclear → COD disputes

Change‑in‑law weak → surprises later

Ambiguity on billing boundary → recurring reconciliation fights

What to demand from Innocepts Solar
Contract annexures: metering boundary diagram + dossier index + O&M SLA.

Open Access Solar for Industries in India

What to do

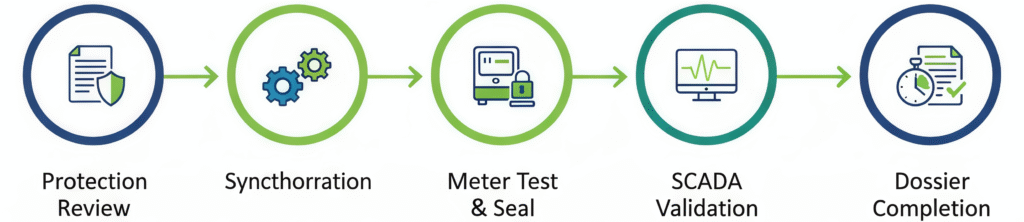

Commissioning must be gated and evidence‑driven:

  • protection settings review and signoff

  • synchronization checks and trial run logs

  • ABT metering open access solar and SEM meter open access testing + sealing evidence

  • SCADA/data availability verification

  • complete commissioning dossier (as-builts, test reports, settings, approvals, logs)

protection settings review and signoff

synchronization checks and trial run logs

ABT metering open access solar and SEM meter open access testing + sealing evidence

SCADA/data availability verification

complete commissioning dossier (as-builts, test reports, settings, approvals, logs)

Where applicable, track statutory steps like CEIG inspection solar project dependencies (state/project dependent).

What can go wrong

  • tripping and rework due to settings/termination/earthing issues

  • meter testing/sealing delays push COD

  • data gaps cause settlement mismatch

tripping and rework due to settings/termination/earthing issues

meter testing/sealing delays push COD

data gaps cause settlement mismatch

What to demand from Innocepts Solar
An audit‑ready dossier index from day one—completed at COD.

What to do
Even offsite solar touches your factory through HT shutdowns, metering work, and relay integration. Treat it like an outage:

  • method statements and LOTO plans

  • permit-to-work discipline

  • QA/QC inspection hold points

method statements and LOTO plans

permit-to-work discipline

QA/QC inspection hold points

What can go wrong

  • missed shutdown window

  • safety risks on factory premises

  • rushed work and inconsistent QC

missed shutdown window

safety risks on factory premises

rushed work and inconsistent QC

What to demand from Innocepts Solar
A site HSE plan + QA/QC pack + photographic evidence and permits.

What to do
Savings stability comes from monthly discipline:

  • compare generation vs delivered vs billed

  • reconcile ABT/SEM meter data with SLDC statements

  • verify banking adjustments and DISCOM charge components

  • run a 90‑day stabilization cadence

compare generation vs delivered vs billed

reconcile ABT/SEM meter data with SLDC statements

verify banking adjustments and DISCOM charge components

run a 90‑day stabilization cadence

This is energy accounting reconciliation open access—and it prevents “infinite billing disputes.”

What to demand from Innocepts Solar
Monthly reconciliation packs aligned to billing boundary + SLDC statements, plus O&M SLA governance.

GOAR + SLDC/DISCOM handoffs stall

Disclaimer: timelines and ₹ impact vary by state orders, SLDC/DISCOM procedure, and project specifics.

Money/savings anxiety

This is the most common reason CFO confidence drops. The project is sold on a headline tariff, but the real number depends on the full stack: wheeling charges open access solar, cross subsidy surcharge green open access, banking charge green open access, standby charges open access, and profile impacts like ToD/DSM (where applicable).

Approvals & coordination delays

GOAR provides visibility, but coordination still matters. Approvals can stall due to documentation loops, interface dependencies, and delays in SLDC approval open access solar coordination with DISCOM/STU requirements.

Metering/energy accounting mismatch

Billing follows regulated metering and settlement statements. If your billing boundary and data discipline aren’t aligned, energy accounting reconciliation open access becomes a long-running fight.

Production shutdown & safety risks

Even offsite solar touches your plant. HT shutdowns, metering changes, and relay work can create production risk if outage planning is weak or safety culture is inconsistent.

Commissioning tripping & data gaps

Projects can be “physically complete” but still unstable due to protection issues, incomplete settings signoff, or data availability gaps—especially when ABT/SEM readiness isn’t treated as critical path.

Under‑generation + slow O&M response

Soiling, inverter downtime, curtailment, and slow response degrade delivered energy and savings. Without an O&M SLA + spares governance, small problems become long downtime.

Pre‑GOAR readiness checklist

Use this before you apply so GOAR doesn’t become a documentation loop:

  • confirm eligibility and connection architecture

  • finalize model (captive / group captive / third‑party PPA)

  • collect 12‑month bills + demand/ToD profile

  • freeze metering boundary diagram

  • map stakeholders and owners

confirm eligibility and connection architecture

finalize model (captive / group captive / third‑party PPA)

collect 12‑month bills + demand/ToD profile

freeze metering boundary diagram

map stakeholders and owners

Metering / SEM / ABT readiness checklist

Treat metering as a critical path:

  • confirm SEM meter open access specs accepted by utility/settlement framework

  • validate CT/PT ratios, polarity, wiring diagrams

  • book testing and sealing slots early

  • define time sync + data retrieval ownership

  • prepare reconciliation template before COD

confirm SEM meter open access specs accepted by utility/settlement framework

validate CT/PT ratios, polarity, wiring diagrams

book testing and sealing slots early

define time sync + data retrieval ownership

prepare reconciliation template before COD

Commissioning + dossier readiness checklist

Gated commissioning prevents billing surprises:

  • protection settings approved and signed

  • earthing/lightning verified

  • SCADA tags verified against billing boundary

  • dossier index locked and completed

protection settings approved and signed

earthing/lightning verified

SCADA tags verified against billing boundary

dossier index locked and completed

First 90‑day billing reconciliation actions

This is how you stop disputes early:

  • Week 1: meter data vs SLDC statement

  • Week 2: DISCOM bill vs charge buckets

  • Week 3: banking settlement validation

  • Week 4: close gaps with evidence log

Week 1: meter data vs SLDC statement

Week 2: DISCOM bill vs charge buckets

Week 3: banking settlement validation

Week 4: close gaps with evidence log

Approval tracker + owner’s engineering pack

A strong EPC runs approvals like a PMO and delivers submission‑ready engineering packs: SLDs, protection philosophy, metering architecture, interface drawings.

Metering + commissioning dossier discipline

A good EPC treats dossier creation as a product: every test, seal, setting, and log is captured and version‑controlled. That’s how ABT/SEM disputes get prevented.

Data/SCADA discipline for dispute‑free billing

Dashboards should mirror the billing boundary and settlement logic. If your SCADA view is “PR data” but billing is “meter/settlement data,” reconciliation becomes conflict.

O&M SLA + spares + response governance

Industrial Open Access Solar needs response governance. Delivered energy is everything—slow response equals savings loss.

Documents/data to collect early (checklist)

Commercial data

Collect early to avoid rework:

  • 12 months electricity bills (energy + demand + ToD)

  • contracted demand / sanctioned load details

  • OA history/penalties (if any)

12 months electricity bills (energy + demand + ToD)

contracted demand / sanctioned load details

OA history/penalties (if any)

Electrical data

  • latest SLD

  • HT panel, CT/PT details, relay make/model

  • meter details (make/class/comms)

  • shutdown windows and constraints

latest SLD

HT panel, CT/PT details, relay make/model

meter details (make/class/comms)

shutdown windows and constraints

Compliance + approvals data

  • facility address/connection IDs (for mapping/aggregation where applicable)

  • stakeholder contact map (SLDC/DISCOM/STU)

  • inspection reports/statutory dependencies (where applicable)

facility address/connection IDs (for mapping/aggregation where applicable)

stakeholder contact map (SLDC/DISCOM/STU)

inspection reports/statutory dependencies (where applicable)

If you want a faster, lower-risk start, Innocepts Solar offers a structured “Approval & Metering Readiness Checklist” walkthrough tailored specifically to your state regulations, DISCOM requirements, and connection architecture. This ensures your documentation, metering design, SLDC coordination, and site readiness are aligned from day one—helping you avoid rework, approval delays, and costly execution gaps while accelerating your Open Access solar commissioning timeline.

It is the end‑to‑end workflow to procure off‑site solar through the grid—feasibility (landed cost), GOAR application, SLDC/DISCOM coordination, ABT/SEM metering readiness, commissioning, and monthly reconciliation.

The GOAR portal green open access is the centralized registry/workflow used to submit and track green energy open access applications and status updates.

Rules and procedures aim to reduce timelines, but actual approvals depend on state processes, submission completeness, and stakeholder coordination (GOAR, SLDC, DISCOM, STU).

Include base tariff plus transmission, wheeling charges open access solar, cross subsidy surcharge green open access (where applicable), banking charge green open access, standby charges open access (where applicable), and other system operation charges and ToD/DSM impacts as applicable.

Because settlement depends on regulated metering and SLDC statements. Time sync, interval data completeness, and the billing boundary must be correct.

Approvals handoffs, metering testing/sealing slots, repeated drawing revisions, protection commissioning issues, data gaps, and incomplete commissioning dossiers (plus CEIG steps where applicable).

Run a 90‑day reconciliation SOP and require evidence‑based monthly reconciliation packs aligned to billing boundary + SLDC statements.

Ask for sample approvals tracker, metering BOM/spec + test plan, commissioning dossier index, reconciliation pack, and O&M SLA with escalation and spares governance.

It can, mainly due to HT shutdowns for metering/protection work. Outage-style planning prevents production disruption.

Always verify the latest state orders and SLDC/DISCOM procedures for your target states (e.g., Haryana, Uttar Pradesh, Maharashtra, Punjab) before finalizing the model and signing contracts.
